Eagles Force Main- Phase II

This project includes installation of new 12" force main segments at Morgan Avenue, Oak Grove Road, and Old Boonville Highway along the east side of Crawford-Brandeis Ditch and various gravity sewer improvements.

Project Team

Project Owner - Evansville Water & Sewer Utility

Evansville, Indiana

Project Designer - Commonwealth Engineers, Inc.

Evansville, Indiana

Construction Engineering Services - American Structurepoint, Inc.

Evansville, Indiana

Contractor - Koberstein Contracting, Inc.

Evansville, Indiana

Road Closures

Click HERE for updated road closures.

Project Update
  • Recent Progress (September 6 to September 12)

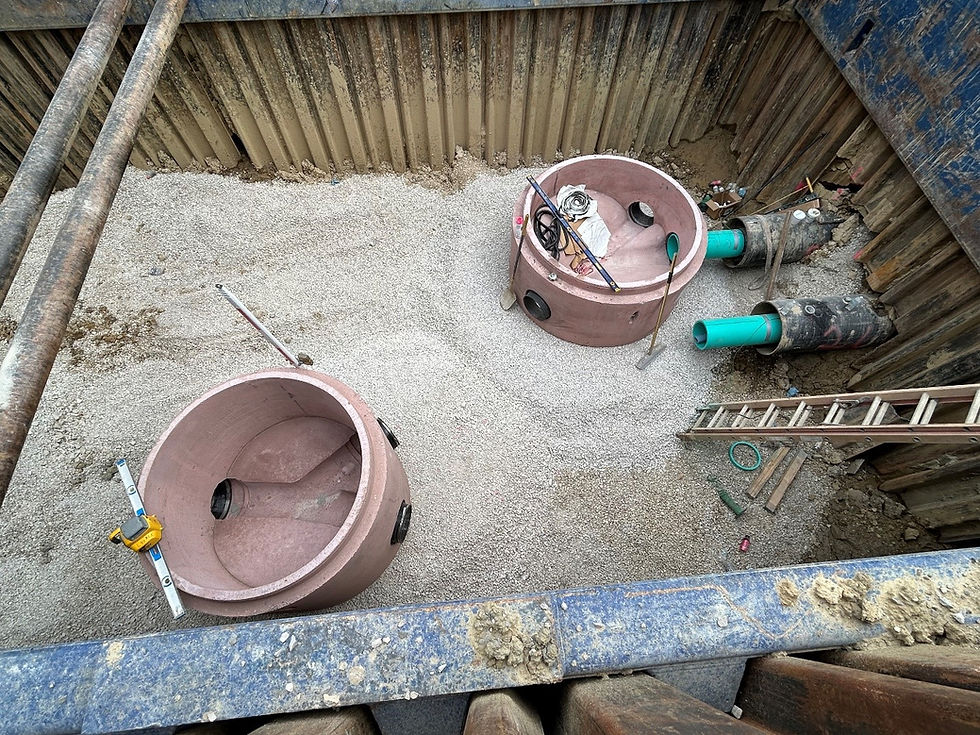

    • Koberstein installed the base sections of SAN MH 07 and SAN MH 08.

    • Koberstein connected the 12” C900 PVC RJ sanitary sewer carrier pipe to SAN MH 07.

    • Koberstein installed new 12” C900 PVC sanitary sewer pipe between SAN MH 07 and SAN MH 08.

    • Koberstein began installing new 12” C900 PVC force main between the 24” steel casing pipe and the existing sanitary force main on the north side of Morgan Avenue.

    • Koberstein performed site restoration at Old Boonville Highway.

  • Anticipated Activities for Upcoming Week (September 13 to September 19)

    • Koberstein intends to begin installing 12” C900 PVC sanitary sewer pipe between SAN MH 08 and SAN MH 10.

    • Koberstein intends to begin installing 12” C900 PVC sanitary sewer pipe between SAN MH 07 and SAN MH 09.

    • Koberstein intends to begin installing SAN MH 05 and SAN MH 06 on the south side of Morgan Avenue.

    • Koberstein intends to begin installing 12” C900 PVC force main on the south side of Morgan Avenue.

Closures

  • Active

    • Westbound Morgan Avenue between Burkhardt Road and Royal Avenue - Lane Restriction

  • Scheduled

    • Eastbound Morgan Avenue between Wayne's Appliance and Spa City - Lane Restriction on/after 9/23/26​

    • Fairfield Drive from Oak Grove to north of IMI -Lane Restriction on/after 9/22/26

Schedule

  • Gravity Sewer installation - September 8 to September 11, 2026

  • Force Main installation - September 28 to September 29, 2026

  • Testing and Connections - September 30 to October 6, 2026

  • Abandon Existing facilities - October 7 to October 13, 2026

  • Restoration - October 14 to October 27, 2026
